Amp-Hour
Amp-Hour / Features / Maintenance

Maintenance

Maintenance tracks what is broken, what is down and what is due. Anyone can report a problem against a piece of equipment or a tank; the work order carries the downtime, the labor and the parts, and a PM raises its work order once it comes due by the calendar or by a meter, checked every hour and again the next time anyone opens Maintenance. Calibration keeps the gauges and the process instruments in tolerance, and shows what an out-of-tolerance instrument touched.

Report a problem

Maintenance > Work orders has a Report a problem button, and the same form is on every equipment page and tank page under Maintenance history. It asks for one line on what is wrong, the Equipment or the Tank, a type (repair, PM, inspection, safety, improvement), a priority (low, normal, high, urgent), who to assign it to, a Needed by date and details. The last checkbox, "The asset is down now", marks the equipment or tank out of service and starts the downtime clock as the order is created.

Any login can report a problem. An urgent order gets a due date of today and a notification to every manager and administrator; a high priority order is due in two days. Assigning the order notifies the person it went to.

Work orders

The Maintenance page opens with a strip of counts: Open, Urgent, Down now, PMs due in 30 days and Downtime hours in the last 30 days. If anything is down, a red banner names the asset and the order, with the time it went down. Tabs split the list into Open, Mine (assigned to or reported by you), Waiting on parts and Done. Each row shows the WO number, priority, the problem with its type, reporter and date, the asset, who it is assigned to, due date and status. A side card lists the most worked assets over 90 days with the number of orders, downtime hours and parts cost.

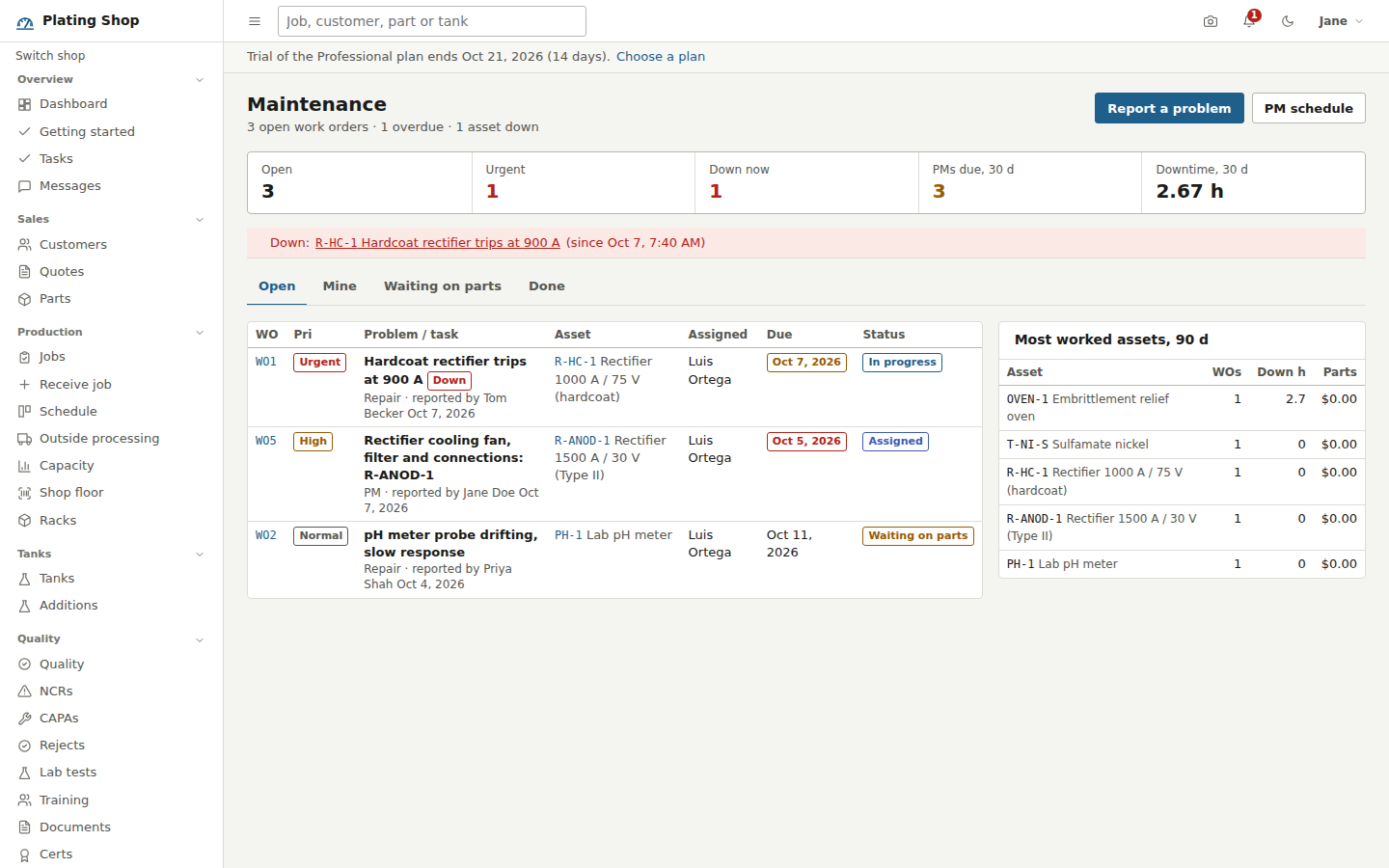

Maintenance page: counts for open, urgent, down now, PMs due and downtime; a red banner that rectifier R-HC-1 is down since Oct 6; three open work orders for a tripping hardcoat rectifier, a rectifier cooling fan PM and a drifting pH meter probe; and a most worked assets card.
Work orders with one asset down. Sample shop.
StatusMeaning
OpenReported, nobody assigned.
AssignedSomeone is named on it. Set when a person is assigned.
In progressStart work was pressed; the start time is recorded.
Waiting on partsSet by hand from Edit.
DoneCompleted with a resolution.
CancelledStays in the history as cancelled.

Work the order

The work order page shows the problem and details, assignment, Needed by, the PM template it came from, start and completion times, the resolution, labor minutes and downtime. Buttons along the top:

Start work
Sets In progress and assigns the order to you if nobody else is on it.
Mark down / Back in service
Runs the downtime clock. Down sets the equipment or tank status to out of service; back in service returns it and adds the elapsed minutes to the order. An out-of-service tank blocks operators from starting a run in it.
Issue parts
Issues a stock item and quantity from Inventory to the order at weighted-average cost; the parts are listed on the order, with their cost for administrators, managers and office staff. In the books they post to Repairs & maintenance.
Edit
Title, type, priority, assignment, due date, status, labor minutes so far, details and the checklist.
Complete
Asks what was done and the labor minutes. A repair needs a resolution. Completing while the asset is down ends the downtime and puts it back in service.
Cancel
Office roles only. An order with parts issued cannot be deleted, only cancelled.

A checklist is one item per line. Ticks save as you go, so a technician can work through it over a shift. Completing a PM with unticked items is refused unless you tick "Complete anyway", in which case the skipped items are noted in the resolution. The reporter is notified when the order is done.

Every completed order on a piece of equipment writes an entry to that equipment's Analysis and maintenance log, and a completed PM sets the equipment's Last Maintained and Next Maintenance Due from its maintenance interval.

PMs

Maintenance > PMs holds the PM templates, with tabs for PMs, Late and Plan. A template names the task (rectifier cooling fan and filter, anode basket inspection, heater and thermostat check), the Equipment or Tank, Every (days), Next Due, estimated minutes, who to assign it to, a checklist and notes. Due by sets how it comes due: by the calendar, by a meter, or whichever comes first. A tank's meters are its own amp-hours and hours run; equipment meters (run hours, cycles, amp-hours) are typed with Read the meter on the equipment page, which also shows the readings. A meter PM has its step ("every 50,000 amp-hours") and the reading it counts from.

When a PM comes due, by date or by meter, it becomes a work order of type PM, titled with the task and the asset code, carrying the checklist with every item unticked, assigned to the named person and due on the template date. The server checks every hour, and opening Maintenance checks too, so the order appears the next time anyone opens Maintenance if the hourly check has not raised it yet; Raise due PMs now does it at once. A template that is already overdue creates its order at high priority. Only one open order exists per template at a time. The person it is assigned to (administrators and managers when nobody is named) is told once when it is raised and once if it goes late. Completing the order moves Next Due forward by the interval and starts the meter count again from the reading at that moment.

Late lists the open PM orders past their due date and the PMs due with no order yet. Plan shows the calendar PMs of the next 30, 60 or 90 days by week, with the estimated minutes per week, and where each meter PM stands.

Equipment and tank pages show the PM schedule for that asset, its work order history and downtime over 90 days. Maintenance > Equipment is the asset list, with the calibration and maintenance due dates of each gauge, rectifier and oven.

Calibration

Maintenance > Calibration is the register of every instrument followed for calibration: overdue and failed first, then due soon, then by due date. Chips pick Overdue, Due, Failed, Process instruments, Standards, or Gauges and meters. Counts across the top give the instruments overdue or failed, due within the reminder window, the process instruments, the out-of-tolerance reviews still open, and what the calibration checks are set to. Work orders says when any instrument is overdue. Print labels prints a small label for each ticked instrument, or for all of them: the ID, the calibration date, the due date and who calibrated it, on 2.4 × 1 in label stock or plain paper. The Calibration card on an equipment page, and each calibration record, have a Label button too.

Setting up an instrument

Open the gauge, meter or controller under Equipment; its Calibration card has Set up:

Kind of instrument
A measuring instrument (thickness gauge, XRF tester, micrometer, thermometer, pH or conductivity meter, balance, hardness tester, surface tension meter, salt spray or humidity chamber), a process instrument (tank temperature controller, thermocouple or RTD, rectifier ammeter or voltmeter, shunt, amp-hour meter, process timer, oven controller or chart recorder), or a reference standard (foils, weights, buffers, a reference thermometer).
Sits on
Nothing for a hand instrument, a tank, or a rectifier or oven entered as equipment.
Calibrate every, next due
The interval in days, and the first due date. Each calibration sets the next one after that.
Tolerance and points
The tolerance in words ("±2 °F") and the points checked each time, each with its nominal value and its tolerance below and above, in the point's unit.
Outside lab
The lab that calibrates it, as a vendor if you like, and its ISO/IEC 17025 accreditation number.
Owner, reminder
Who gets the reminders, and how many days before the due date (14 unless changed under Settings > Quality).

Recording a calibration

Record calibration takes:

  • The date, and who did it: in house, or the lab with its accreditation number and certificate number.
  • The reading at each point as found and as left. A blank as left means it was not adjusted. Each point says at once whether it is in or out of tolerance.
  • The standard used, from the register or typed, with its certificate (its latest certificate when left blank).
  • The next due date (the date plus the interval, unless changed), the conditions and notes.

Attach the lab's certificate to the record after saving. Saving warns, without refusing, when the standard was itself overdue on that day, when an outside lab gave no certificate or accreditation number, or when there is no next due date.

Left in tolerance, the instrument's dates move on, and one taken out of use by a failed calibration goes back in service. Left out of tolerance, it is taken out of service and counts as overdue until it passes. Only the latest record moves the dates; one typed in late for an earlier date is kept but changes nothing. A record entered by mistake can be voided with a reason: it stays on file, and the dates go back to what they were. The old Log entry on the equipment page still records tank analyses, maintenance and repairs.

Process instruments

Temperature controllers and thermocouples on a tank, ammeters, voltmeters, shunts and amp-hour meters on a rectifier, process timers, and oven controllers and chart recorders sit in the same register, each linked to its tank, rectifier or oven. A rectifier or oven followed for calibration counts too. When a load, a step or a bake starts on a tank, rectifier or oven whose instrument is overdue or failed, the shop's setting decides what happens: warn (the default), block, or off. A load's page lists the overdue instruments on its tanks.

Out of tolerance: the impact list

When a calibration finds an instrument out of tolerance as found, administrators, managers and QC are told, and the record shows the impact list: everything that used the instrument since its last good calibration.

  • Thickness readings, QA tests, lab results and chrome surface-tension readings taken with it.
  • Loads and steps run in the tank, rectifier or oven it controls, and bakes in its oven.
  • Instruments it calibrated as a standard.
  • The jobs, and the certs issued after it was first used.
  • Each customer, with their jobs, certs and shipped jobs.

Open NCR opens one NCR for the event, or one per customer, naming the job when there is only one. Draft notice opens Email this to that customer: the message lists their jobs, POs, shipped quantities and certs, with a PDF. Mark reviewed records what the review found and closes it on the counts; it can be reopened.

Checks and reminders

A thickness reading, a QA result or a lab result entered with an instrument that is overdue or failed its last calibration warns (the default), or is refused when the shop blocks it under Settings > Quality; then an administrator, manager or QC can go ahead with a reason, which is logged. Each morning the server tells an instrument's owner (when it has none: administrators, managers, QC and roles with Maintenance) about the instruments coming due and those overdue, once per instrument and stage.

Where it surfaces

Urgent and overdue work orders and anything down are on the Dashboard under Outside processing and maintenance. Notifications for assignments, urgent orders, PMs due, calibrations due and completed orders go to the bell in the top bar and the Notifications page. The module can be switched off under Settings if your shop does not use it.
