Quality
Quality is built into the job: QC cannot sign off a step of a job that requires thickness readings until they are entered, and every reject carries a reason code and a disposition. The Quality menu has nine pages: the Quality overview, QA tests, NCRs & CAPAs, Rejects & returns, Incoming, Certs, Specs, Deviations, and Training & documents. NCRs & CAPAs, Rejects & returns and Training & documents each hold two lists as tabs; the NCR, CAPA, return and document lists have chips that filter the list and count what is in it. QA tests (thickness, adhesion, salt spray and the other tests run on parts, and the hydrogen embrittlement relief bakes) are listed under Lab too. Calibration is kept under Maintenance and counted on the overview. Six quality checks (training at step start, calibration on readings, calibration at load and bake start, spec revision at receiving, an open NCR at shipping, a discrepancy at incoming inspection) each warn, block or stay off, as the shop chooses under Settings > Quality.
The Quality page

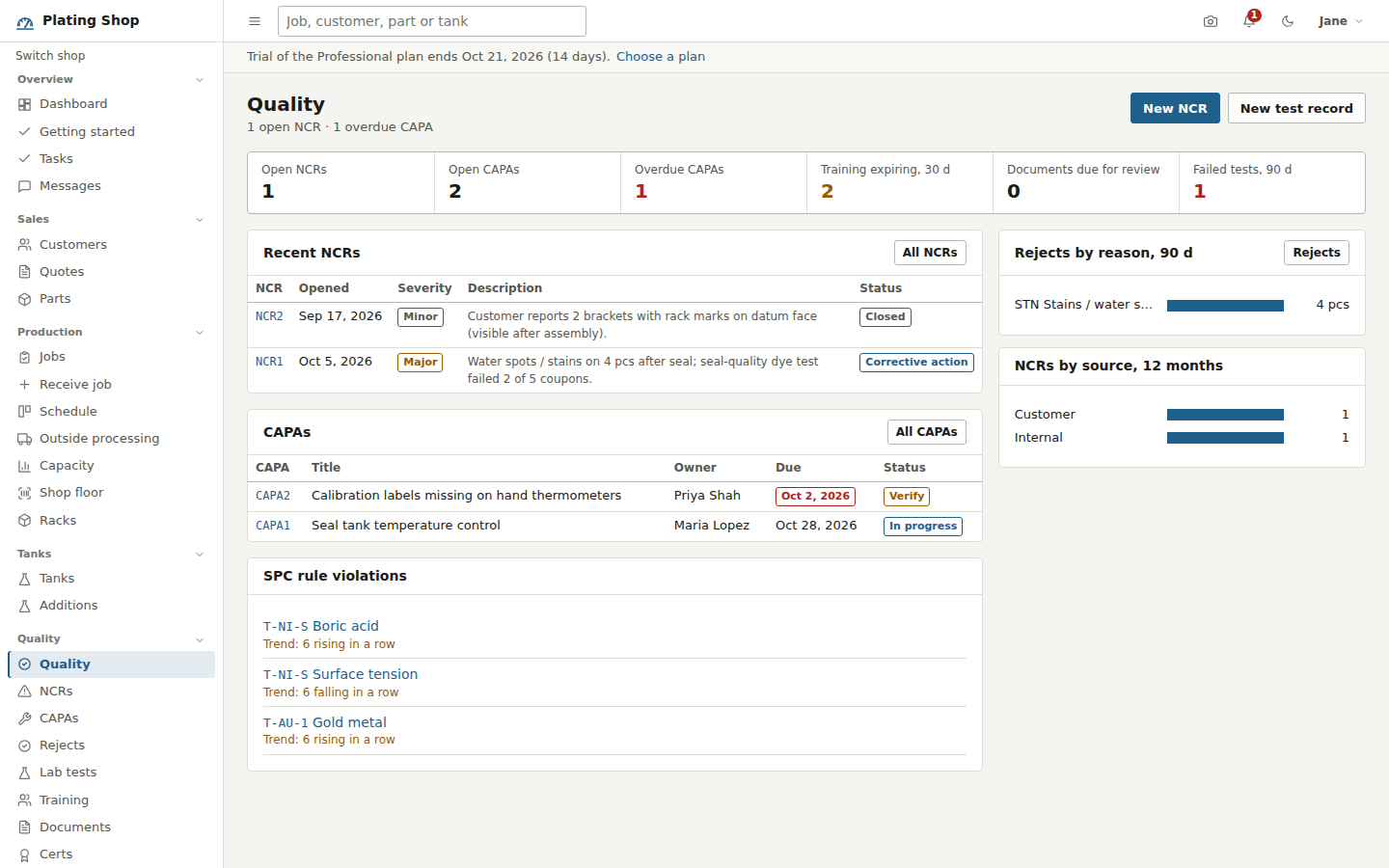

Quality opens on counts, each a link to the list it counts, already filtered: open NCRs, open CAPAs, overdue CAPAs, open customer returns, pieces rejected in the last 90 days, training expiring within 30 days (or already expired), documents due for review and failed QA tests in the last 90 days. A shop with Maintenance also sees the equipment due for calibration, and one with Polishing the pieces waiting for polishing inspection, each for the people whose role includes that module. Below them is one list of the open NCRs and CAPAs, overdue CAPAs first, with owner and due date; the SPC rule violations on tank chemistry, for roles that include Tanks; and NCRs by source over twelve months. A strip of QA test counts and a New QA test button sit at the top.

Thickness readings and QC sign-off
Readings are entered on the job page or from the Readings button on the shop floor terminal: one or more values in the job's unit (mil, in, µin or µm), the location on the part, and the gauge from the equipment list. The job shows n, minimum, maximum and average with a pass or fail against the tolerance, and each reading outside it is marked. When the job requires readings (the part's "Thickness readings required" box, copied to the job when it is received; for a job with no part, when it has a thickness range), a QC operation cannot be completed until at least one reading exists, on the job page or for a shared load; the Complete dialog says so. A job that does not require them passes QC without readings, and readings can still be recorded on it. One set of readings per job covers every QC portion by default; with "Readings per QC portion" on in Settings, each QC portion (a rack, a load) needs its own, and each shipment's cert lists the readings of the pieces it carries. Polishing inspections are never held for readings, since plating comes after them. The readings, the gauges and their calibration dates are snapshotted onto the cert at shipment. A reading taken with a gauge that is overdue for calibration, or failed its last one, warns as it is entered, or is refused when the shop blocks it (see Quality checks below).
Final QC sign-off
Completing a QC step runs the sign-off checks, and the QC Complete dialog lists each one with what it found and what would let the step go ahead. Thickness readings: when the job requires readings, or has a sampling plan and a thickness range, the step needs as many readings as the sampling plan's sample size for the lot, else the count the traveler asks for (such as "min. 5 locations"), else one. A job with no thickness spec and no sampling plan needs none, so the Final Inspection step of a process with no steps of its own is never held for readings. A step with a reading outside the tolerance, or with too few readings, is refused until the pieces are rejected, an NCR on the job or an approved deviation or waiver answers for them, or an administrator, a manager or QC signs off with a reason; each of these is logged under Quality checks. This check is always on.
Hydrogen relief bake: a bake step cannot be completed until its bake record is finished, with the hours the step asks for (its minimum time), whether it is completed on the job page, on a load or at the shop floor terminal (see Quality checks). A bake cannot ask for fewer hours than its step; one recorded as starting before the step it follows was done needs an administrator, a manager or QC to sign off with a reason; and a bake waiting for review counts only when it passed on its own figures. Time in process: the QC dialog flags an earlier step whose recorded run was shorter than its minimum time, so QC can look before signing off; it never stops the sign-off.
Bake adhesion test: when a test plan asks for a bake adhesion test, the job's last QC step cannot be signed off until the test has passed, or an approved deviation or waiver that names the bake test is chosen in the dialog; no other release counts (see Bake adhesion test). On a shared floor terminal, and on the job page, the operator is rarely the one who may sign off over the thickness or hydrogen relief bake checks: Supervisor approval in the dialog takes an administrator's, a manager's or QC's badge, PIN and reason on the same device, as it does for training and calibration. It is logged under the supervisor's name, given for that operator, that check and that step, and used once.
A sampling plan is set on a part, a customer or a process, and the part's wins, then the customer's, then the process's. A job keeps the plan in effect when it was received, as it keeps its specs, so a plan set later applies to new jobs only. Every shop starts with accept-on-zero (c=0) plans and ANSI/ASQ Z1.4 general inspection level II plans at AQL 0.65, 1.0, 1.5, 2.5 and 4.0; they are starter values, so check them against your copy of the standard and the customer's requirement. Record readings, the QC Complete dialog and incoming inspection say what the plan asks of the lot, such as "Sample 13, accept 0".
Readings can be typed in in, mil, µin or µm, or with the unit written after the number ("0.38 mil", "9.6 µm"). They are converted to the job's unit, and the value as typed is kept with its unit for the record. Each person's last unit is their default the next time. A wrong reading is voided with a reason by QC or the office instead of being deleted: it stays on the job, struck through with the reason and who voided it, and it leaves the verdict, the sign-off and the cert.
Rejects
Rejects are recorded when an operation is completed, on receipt from an outside processor, or from Record reject on the job: quantity, reason code, the operation they were found at, the source (found in-house or a customer return) and a disposition. Strip and replate creates a linked rework job; the other dispositions are scrap, use as is and return to customer. At a polishing step or its inspection, Back to the polisher (the default there) sends the pieces back to the polisher who did them as unpaid rework, recorded as a polishing inspection; strip and replate is not offered there (see Polishing team). Rejects & returns opens on the Rejects tab: every reject event for a date range and source (internal, customer returns or polishing inspection) with totals of pieces rejected, reworked and scrapped, a Pareto of reasons and the reject rate by process. A job built from a part's traveler counts its rejects under the traveler item or line they were found at, and polishing rejects count under the paid polishing item, so every bar carries a name. Each chart links to its full report and CSV under Reports for the same dates. A polishing-inspection row opens that inspection, a customer-return row names its return, and each row has a button that opens an NCR pre-filled with the job, quantity and reason.
NCRs
A nonconformance report is numbered by the shop's own sequence and opened from NCRs & CAPAs, from a job (Open NCR) or from a reject. The NCRs tab lists all open NCRs, those in CAPA, closed ones, or all.
| Field | Values |
|---|---|
| Source | Internal, customer, supplier, audit |
| Severity | Minor, major, critical |
| Customer, job, part, quantity affected | Linked records; the NCR appears on the job page |
| Description, containment, root cause | Text; root cause as 5 whys or fishbone |
| Disposition | Rework, scrap, use as is, return to customer, repair, regrade |
| Cost of quality, owner | The owner is notified when the NCR is assigned to them |
| Status | Open, investigating, corrective action, closed; the form moves it between the open ones, and only the buttons below close and reopen it |
Close NCR requires a disposition and takes the root cause. Open CAPA creates a corrective action from the NCR, copying its description and root cause, and moves the NCR to corrective action. Reopen, on a closed NCR, puts it back to open (or to corrective action while its CAPA is open) and keeps the disposition; it is recorded in the audit log. Open CAPA on a reopened NCR whose CAPA is still open goes to that CAPA and puts the NCR back in corrective action. When nonconforming parts are to ship as they are, ask the customer for a waiver first (see Customer deviations and waivers below).
CAPAs
A CAPA is corrective or preventive, with a source (NCR, audit, customer, internal, management review), the related NCR, a title, problem statement, root cause, action plan, owner and due date, 30 days out by default. The CAPAs tab lists all open CAPAs, those awaiting verification, overdue ones, closed ones, or all. Action items are tasks assigned to people with their own due dates; they show on the CAPA and in each person's Tasks list. Record verification writes how effectiveness was checked, for instance no recurrence in 60 days. Marking it effective closes the CAPA and its NCR together; not effective puts the CAPA back in progress. On the form the status moves between open, in progress and verify (awaiting verification); only Record verification closes it. Reopen, on a closed CAPA, clears the effectiveness check (its text stays as history), puts an open NCR it came from back in corrective action (a closed NCR stays closed) and is recorded in the audit log.
QA tests
Quality > QA tests (also under Lab) holds the tests run on parts; bath titrations and meter readings are tests of the tank, on its test screen (see Tank chemistry). It replaced the Lab tests page: every old Lab test was copied in once, with its files, and old links still open it; hull cell rows became Hull cell panels on their tank. The page has six tabs: To do, All tests, Chamber, HE bakes, Templates and Plans. Anyone on staff can start a test and record results; templates, plans, reviewing a result, voiding a test and opening an NCR from one are for QC, office staff, managers and administrators.
To do is the worklist: HE bakes to start and in the oven, inspections due, tests due and running, results to review, steps that must start soon, and periodic tests coming due. All tests lists every test with chips for its status (open, due, planned, running, to review, passed, failed, void), a date range and a search.
Templates
Fifteen starter templates: coating thickness (ASTM B568, B499 or B244); adhesion by bend, tape, file and heat-quench (ASTM B571); neutral salt spray (ASTM B117, with inspections at 24, 48, 72 and 96 hours); humidity; porosity; microhardness; coating weight; seal quality; solderability; the hydrogen embrittlement relief bake (ASTM B850); the ASTM F519 sustained-load test; and Other. A template names the spec, the number of specimens, the hours and inspection points of an exposure test, the equipment it runs in, whether QC must review the result and whether it prints on the cert. Pass or fail is worked out by one of the lab's part-test methods, with the spec's values held on the template. The starter values are examples, marked "check against your spec" until someone ticks Checked against the spec. The office adds and edits templates.
Test plans
A plan says which tests a part needs: for a part, a process, a customer or a combination (all those set must match), every job, every lot, every shipment or every so many days, whether the result prints on the cert, and whether a fail holds the job. A matching job gets a planned test, which falls due once its plating is done; a plan by days raises a due test on its date. The server checks the plans every five minutes.
Recording a test
A test's page shows the job, part and spec, and what to do next. Start the test starts an exposure test's clock in its chamber. Record result takes the values the method asks for, with the spec's values filled in, the specimens with their ratings, and photos; a thickness test takes the job's own readings and thickness range. The result card shows the values used and the pass or fail. An exposure test is inspected at its set hours, each with its result and photos (Inspect at another hour for an extra look), and the server sends a reminder when an inspection is due and when the test has run its hours. When the template asks for review, the result waits under To review until QC accepts it (Accept the result) or sends it back with a note.
A failed test tells administrators, managers and QC. Open NCR opens a nonconformance report with the job, part and customer filled in, and the job goes on hold when its plan says so. A test can be voided with a reason.
The salt spray chamber board
The Chamber tab shows each chamber (equipment with the daily salt fog check, or named for salt, fog, humidity or a chamber) with the tests running in it, the hours so far and the next inspection, and refreshes every minute. A test page warns when its chamber's daily check has not been done.
Hydrogen embrittlement relief bakes
Any step with a Must start within limit and pieces waiting carries a countdown on the job page, the Schedule board and the shop floor terminal, from when its oldest waiting piece came off the step before. Administrators, managers and QC are told once at half the window, once at 80% and once when it is late. A step counts as a bake when its name says bake, embrittlement or HE relief, or when the job has an HE bake test planned. Start bake, on the job page or the shop floor terminal, records the oven, the set point and temperature window, the hours required, the start window, when plating finished (filled in from the countdown) and when the bake started; Finish records the end, the average temperature and the hours at temperature, which cannot be more than the time in the oven. The bake conforms only if it started inside the window, ran long enough and stayed in the temperature window, and the record says why when it does not. Temperatures are kept in °F; a value typed in °C is converted. The HE bakes tab lists bakes waiting, in the oven and done.
The bake hours, the start window and the temperatures depend on the part's strength class and the plating spec (ASTM B850, AMS 2759/9). The starter values, start within 4 hours of plating and 8 hours at 350 to 400 °F, are placeholders: verify them against your spec before relying on them.
When the bake step sets its own minimum time and temperatures, Start bake is filled in from the step: a 23-hour step at 365 to 395 °F starts as 23 hours required with a set point of 380 °F.
Bake adhesion test
Some customers prove adhesion with a bake test: plated parts or coupons are heated to a set temperature for a set time, quenched or not, and then looked at for blistering, peeling or flaking (ASTM B571 heat-quench). It is a test of the coating and is separate from the hydrogen embrittlement relief bake: it has no start-within deadline after plating, it is not on the HE bakes tab, it never counts as an HE relief bake, and an HE relief bake never counts as a bake adhesion test.
It is set up as a test plan of the kind Bake adhesion test on a part, or on a customer or a process for all their jobs, with the set point in °F or °C, the time, whether the samples are quenched and in what, whether they are parts from the lot or coupons and how many, the spec and whether a pass prints on the cert. Each job the plan covers gets the test with those values. The traveler prints each bake adhesion test on its own line under the steps, with the test, its spec, the set point and time, the quench and the samples, and boxes for the oven, the times in and out, the result and who checked it.
Until the test passes, the job is held: its last QC step is not signed off, and no certificate of compliance is issued for it, neither with a shipment for a customer who requires certs nor with Issue cert on the job page. The QC Complete dialog and the refusal both say where the test stands. A pass on the job, on the job its lot was split from, or on another job of the same lot for the same customer releases it. So does an approved deviation or waiver in effect for the job that is about the bake test: its title or its characteristic says bake test (or bake adhesion test), or gives the test's number. One about another requirement that only mentions the bake test, such as a thickness waiver whose proposed value adds that the bake test still applies, does not release it. At final QC it is chosen in the dialog; a certificate issued under it is noted in the gate log. A failed or voided test does not release the job, and neither do rejected pieces, an NCR or a supervisor's reason.
On the cert
Passed tests marked to print on the cert, on the job or on its lot, are listed on the certificate of compliance in a Tests table, and passed bakes in a hydrogen embrittlement relief table with the oven, the times and the temperatures (see Certs, shipping and packaging). The cert and the traveler also carry the part's drawing revision as it was when the job was received (see Jobs, travelers and routings); changing a part's drawing revision is recorded, with the part's traveler as it stood, and the part's page lists its drawing revisions and the test plans that apply to it.
Incoming inspection and damage reports
Customer parts are checked as they come in. Receive job has an Incoming inspection section, folded until it is used:
- The count on the packing list and the count you made. The count fills Quantity when Quantity is blank.
- The condition: OK, damaged (what is damaged and how many pieces) or contaminated.
- Contamination: rust, oil or grease, scale, old coating, other.
- The base material, the hardness (HRC 40) or the strength class (10.9, Grade 8, 180 ksi), and notes.
A line under the boxes says what will be recorded as you type: "Counted 480; the packing list says 500 (20 short)." The same record can be made later with Record inspection on the job page. Record damage, also on the job page, is for customer parts damaged in the shop: what was damaged and how, the step where it was found, the cause (damaged in our shop, arrived this way, not known) and the pieces affected.
A count that differs from the packing list, damaged or contaminated parts, and every damage report are discrepancies. What happens next follows the shop's setting (see Quality checks):
- Warn (the default): administrators, managers, QC, the customer's sales rep and whoever received the job are told. The office can tick Put the job on hold.
- Block: the job goes on hold by itself. An administrator, manager or QC can let it in without a hold, with a reason.
- Off: it is recorded, and nobody is told.
After saving, a short dialog shows what was found and takes photos, from a phone camera or a file. Email the customer opens Email this with the report as a PDF, the photos attached and a message asking how to go on (and saying the job is held, when it is).
Hardness feeds the hydrogen embrittlement check. Steel counts as high-strength from HRC 31 (a setting under Settings > Quality; check it against your customer's spec), from a strength class of 1000 MPa, or when the job's material is a high-strength steel. The inspection then says the parts need a hydrogen relief bake after plating, and warns in red when the job has no bake step.
Quality > Incoming lists every inspection and damage report, with chips for Open, Discrepancies, Damage, Resolved and All, and a search by job, PO, customer or part. "Customer not told" marks a discrepancy that has not been emailed. A record's page has the facts, the photos, Email the customer, Open NCR, Mark resolved (with how it was settled), Edit, Void (kept on file, marked void), the job's hold with Release, and the history.
Holds
A hold stops the work: no step, polishing run or load starts on a held job, and nothing ships from it. Each hold keeps who placed it, when, why and where it came from: put on hold by hand, an incoming inspection, a damage report or a failed QA test. The job page shows a red ON HOLD banner with the reason and a link to the record, and the Holds card keeps every hold with its release. Place on hold asks why. QC, office staff, managers and administrators release a hold; one from an incoming inspection or a damage report needs the reason it can go (for example, what the customer said). An operator who tries to start a held job is told the reason and that QC or the office releases it.
The spec library
Quality > Specs keeps the specifications your customers call out. A spec has:
- A spec number (ASTM B633, AMS 2404, a customer's own ACME-PS-101) and a title.
- An issuer: a customer, AMS, ASTM, MIL / federal, SAE, ISO, your own or other. The customer whose spec it is, when it is theirs.
- An owner, who is told when a new revision comes in.
- Flow-down notes: what the customer's PO or quality clauses add.
- The spec documents, as files.
Typing a number such as "MIL-A-8625F Type II" reads the issuer (MIL), the revision (F) and the type from it.
Each spec has its revisions, each with an effective date, what changed and its own file. Which one is current is worked out from the dates: the latest revision in effect is current, a later-dated one waits as upcoming, and older ones are superseded. A revision issued by mistake can be marked withdrawn.
Used by links the spec to the parts, processes and customers that use it, each with the type, class or grade it is called out at and the customer's own requirements. A customer link puts the spec on every job for that customer when "Every job for this customer" is ticked, the default for the customer's own spec. Unticked, it only adds the customer's requirements where a part or process brings the spec in. A new link can go on the open jobs it reaches at once; otherwise only jobs received from then on get it.
The spec and revision on every job
When a job is received it keeps a copy of its specs at the revision in effect: from its part, its process, its steps and the customer's links. A rework job copies its original's, and a split lot its parent's. Later changes to the library do not change the copy.
- Receive job lists the specs the job will get, with a revision picker for a PO that calls for an older revision. An older revision asks why it is kept.
- The job page has a Specs card: each spec with its revision, type or class, the customer's requirements and the flow-down notes. The office can add a spec or take one off.
- The traveler prints the same lines.
- The certificate of compliance prints the spec and revision from the job's copy (see Certs, shipping and packaging).
A new revision
New revision on a spec's page shows, before it is saved, who will be told and which open jobs will still be on the older revision.
- Dated today or earlier, it replaces the current revision at once. The spec's owner, whoever received the open jobs on the older revision, the sales reps of the customers who use it, and administrators, managers and QC are told, with the open jobs still on the older revision listed.
- Dated later, it waits as upcoming, and the notice goes on the morning it takes effect.
Open jobs keep their revision until someone acts. A job on a replaced revision shows a warning on its page with Move to rev 23 and Keep rev 19; Keep asks why (for example, the customer's PO calls for it). Receiving a new job to a replaced revision warns, or is refused without a reason, as the shop chooses. The spec list counts the open jobs on an old revision.
Specs typed as text
A process whose Specification field is plain text keeps working as before. The spec list shows it under Not in the library, and so does the Specs card of a job on that process. Add to library creates the spec, or finds it when it is already there, reads the revision and class from the text, links the process, and puts the spec on that process's open jobs.
Customer deviations and waivers
When work cannot meet a requirement, ask the customer before it ships. Quality > Deviations holds each request. A deviation is asked before the work is done; a waiver after, when the work is done and does not meet the requirement. A request names:
- The customer, and a title they will recognise.
- What deviates: the spec (from the library, or as written), the clause, the characteristic, what is required and what is proposed or was made.
- Why you ask.
- What it covers: jobs, lots, or a part when no job or lot is named; a quantity limit and an expiry date, both optional.
- The customer's reference, the NCR it comes from, internal notes the customer never sees, and photos and files.
The job page's Deviations card lists the job's open NCRs, each with Ask the customer for a deviation. That fills in a waiver from the NCR: the customer, the job, the part, the quantity and the description. A row on the Ship page held back by an open NCR has Ask for a deviation too, filled in from the job.
A new request is a draft. Email sends it with Email this: a PDF of the request and an approve or decline link that needs no sign-in. Sending the email marks it as waiting for the customer. Send to the portal shows it to their portal users. The customer approves with their name, title and date, or declines with their name and a note, on the linked page or in the portal. Their answer, the time and how it came are kept, and the office is told. An answer given by phone or on paper goes in with Record the answer. New link stops the old link working, and so does cancelling the request.
An approved request covers its named jobs (and jobs split from them), its lots, or its part, until its expiry date and while pieces are left under its quantity limit. A shipment under it prints a line on the certificate of compliance, "Shipped under waiver D-1, approved by Dana Buyer (Quality Manager) on Oct 15, 2026", and counts its pieces. It expires when its quantity has shipped, or on its date (checked each night); voiding a shipment gives its pieces back. The list has chips for drafts, waiting for the customer, approved, declined, expired, closed and cancelled, and each request keeps its emails and its history. Close ends one that is no longer needed.
Shipping a job that has an open NCR, with no approved deviation covering the pieces, warns on the Ship page. When the shop blocks it, only an administrator or a manager can ship it, with a reason that is kept on the shipment.
Training matrix
Training & documents opens on the training matrix: people against courses. Each cell shows the level (trainee, qualified or trainer) with the expiry date, or Missing, Expired or Expiring, and is blank where the course is not needed. A course is needed by the roles named on it, and by anyone marked as needing it. Counts across the top give missing, expired, expiring soon and trainees, and whether the check at step start is off, warn or block. Chips switch to Courses, Due (expiring and expired) and, for the office, Check log (the warnings and overrides at the start of work).
A course has a code and title, a renewal period in months, the days before expiry to remind, the roles that need it, and files such as the slides or the work instruction it teaches. It also says what it qualifies someone for: processes, tanks, tank groups, lab methods and polishing operations. A tank group covers every tank in it. Checked at step start makes the course count in the check below. On the job means a trainer signs each person off.
Tapping a cell opens what can be done there:
- Record training: the level, the date, the expiry (from the course's renewal when left blank), the trainer, a score and notes. On an on-the-job course, a trainee is moved up with Sign off.
- Mark as needed or Not needed for that person.
- Withdraw a qualification, with a reason. The record stays, marked withdrawn.
- Allow for the shift (below).
The office and QC record training. A current trainer on a course can sign others off on it, but not themselves. Making someone a trainer is for administrators, managers and QC. Each person has a page with their courses and history, and My training shows your own. Each person is reminded once when a qualification is coming due (30 days before, unless changed) and once when it expires, and administrators, managers and QC get a summary.
Training checked when work starts
When someone starts a job step, a polishing run or a load, or enters a lab result, the server checks that they hold every course linked to that work (its process, tank or tank group, polishing operation or lab method) as qualified or trainer, and not expired. The shop chooses what happens when they do not:
- Warn (the default): the work starts and the person sees what is missing. The warning is logged, and the matrix marks them as needing the course.
- Block: the start is refused, with what is missing. An administrator, manager or QC, or a trainer on that course, can start it with a reason, which is logged.
- Off: not checked.
A course can also be linked to an instrument (one gauge, such as G-XRF-1) or an instrument type (every thickness gauge, every pH meter). Then anyone who enters a thickness reading, a QA result or a lab result taken on that instrument is checked the same way, and the warning or refusal names the course; a standardization weighed on a balance is checked for the balance.
Allow for the shift, on a matrix cell, lets a supervisor or a trainer on the course allow a person to work without it for a few hours (up to 72), with the reason; for example, while they work beside a trainer. Each start in that time is logged with the name and the reason, and Check log shows who is allowed now, with End now.
Controlled documents
The Documents tab holds procedures, work instructions, forms, specifications, policies, the quality manual and drawings, each with a number, a revision starting at A, an owner and a review date. A new document is a draft. Approve records the approver and the effective date and sets the next review a year out; a document is approved by a manager, administrator or QC other than its owner. Revise on an approved document archives the approved text into the revision history, requires a change summary and opens the next revision as a draft. Make obsolete withdraws a document while keeping it for the record. Chips list the approved documents, those due for review, drafts, obsolete ones, or all.
Calibration
Thickness gauges, XRF testers, thermometers, pH meters and the instruments on tanks, rectifiers and ovens are calibrated under Maintenance > Calibration. Each record keeps the values as found and as left at each point, the standard used and its certificate, the lab and its ISO/IEC 17025 accreditation number, and the lab's certificate. When an instrument is found out of tolerance, its impact list shows every reading, test, lab result, load, bake and cert that used it since its last good calibration, with an NCR and a customer notice one click away (see Maintenance). The certificate of compliance quotes each gauge with its calibration dates.
Quality checks: off, warn or block
Settings > Quality, for administrators and managers, sets six checks. Each is Off, Warn or Block:
- Warn is the default, and suits a general, decorative or chrome shop. The work goes ahead and says so, and the warning is logged.
- Block stops the work until it is fixed, or until someone allowed to go ahead gives a reason, which is logged.
- Off does not check.
- Training at step start
- Someone starts a job step, a polishing run or a load, or enters a lab result, without the training for it. On Block, an administrator, manager or QC, or a trainer on that course, can go ahead.
- Calibration on readings
- A thickness reading, QA result or lab result is entered with an instrument that is overdue or failed its last calibration. On Block, administrators, managers and QC can go ahead.
- Calibration at load, step and bake start
- A load, a step or a bake starts on a tank, rectifier or oven whose instrument is overdue or failed. On Block, administrators, managers and QC can go ahead.
- Receiving to a replaced spec revision
- A job is received to a spec revision that has been superseded or withdrawn. On Block, whoever receives it gives the reason the job stays on it.
- Shipping with an open NCR
- A job with an open NCR ships without an approved deviation that covers it. On Block, only administrators and managers can ship it.
- Discrepancy at incoming inspection
- The count differs from the packing list, or parts arrive (or get) damaged or contaminated. On Block, the job goes on hold; administrators, managers and QC can let it in without a hold.
The same page also sets the Hydrogen relief bake record at bake steps check: a hydrogen embrittlement relief bake step is completed without a finished bake record of the hours the step needs. It is Block unless changed, and on Block administrators, managers and QC can go ahead with a reason.
The same page sets the hardness from which steel counts as high-strength (HRC 31 unless changed), the days before expiry or due date that training and calibration reminders go out (30 and 14 unless changed), and lists the recent warnings, overrides, holds and kept revisions with who and why.
One dialog answers every check, on the shop floor terminal, the job page, loads, polishing, the lab, QA tests and the Ship page. It says what is missing or overdue. For someone allowed to go ahead it asks "Why is it OK to start?" (or to use the instrument, or to ship) and sends the request again with the reason; anyone else is told who can go ahead. On a held job, QC and the office can release the hold there, with the reason, and carry on.
Customer returns
When a customer sends parts back, open the return from the shipped job's page with Customer return (RMA). It asks how many pieces, the reason code, what the customer reported, their own reference number, and the disposition: rework at no charge, replace, credit, scrap, or evaluate first. The return gets its own number (RMA1, RMA2 and so on, with the prefix you choose), is linked to the original job, and is recorded as a customer reject so the reject statistics show it.
With the rework disposition a new job opens at once at priority 1 and no charge, carrying the original routing, part and specification, marked with the return number and the original job. If the parts have not arrived yet, untick "The parts are already here" and the rework job waits on hold; Parts received releases it and sets its quantity to what actually came back. Shipping the rework job closes the return by itself. Credit, replacement, scrap and evaluation returns are closed by hand with a line on how they were resolved and, for credits, the amount.
The Returns (RMA) tab of Rejects & returns lists all open returns, those in rework, closed ones, or all; each has a printable return authorization to send the customer and to travel with the parts, and a link to open an NCR for the complaint. The Quality page counts open returns.
Audit trail and record history
QC reads the shop's audit trail as administrators, managers and the office do: Audit trail on the Quality page opens it (it is also under Setup). It lists changes newest first, 100 to a page with the total, and filters by kind of record and record number, with the record's own lines such as a tank's parameters or a job's operations, by person, by kind of change, by words and by dates. Download CSV gives every row the filters match, and each row links to the record it changed. Changes to Settings, to appearance, fields and terms, and to a process's routing show the old and new values.
Part, process, tank, customer and job pages end with a History card of the record's latest changes, with a link to its full history. Job, customer, quote and invoice pages have Add task, which links the task to the record, and the Tasks page names the linked record and opens it. Deleting a task asks first; a thickness reading is never deleted, only voided with a reason.
Open NCR on a job fills in the job's customer, part and quantity, and an NCR saved with only the job number takes them from the job. NCR and CAPA owners, and the people tasks and action items are assigned to, are chosen from the shop's staff, never a customer's portal login. The NCR page has Trace a chemical lot for a complaint that may come from the chemistry.
