Amp-Hour
Amp-Hour / Features / Environmental compliance

Environmental compliance

A plating shop answers to a wastewater permit, the hazardous waste rules and whoever inspects the SDS binder; a chrome shop also answers to the chromium electroplating air rule and OSHA's hexavalent chromium standard. Amp-Hour keeps those records next to the production records they come from, and flags the ones that are about to be late.

Compliance dashboard

Environmental > Compliance opens with six counts: wastewater samples in the last 30 days (with the last sample's date and point), open exceedances (and their tasks that are late), containers on the accumulation clock (with the oldest in days), manifests awaiting the signed copy, permit deadlines in the next 90 days and chemicals without an SDS. Each count links to its page. A Chrome card follows for chrome shops: the tanks overdue, due a re-test or due soon for a surface-tension reading and, for administrators and managers, Cr(VI) monitoring and exams due in the next 30 days; the same reminders lead the Quality and compliance list on the main dashboard. Record a sample is at the top, and a banner says so while no wastewater limit set is turned on. Below are the effluent pH of the last 30 days with the minimum and maximum read, the permit and report deadlines table, the containers on the clock with their days, and the chemicals missing an SDS.

Compliance dashboard: counts for samples, exceedances, containers on clock, manifests awaiting copy, deadlines and chemicals without SDS; an effluent pH chart for 30 days with limit 6 to 9; a permit deadlines table; and four waste containers with days on the clock.

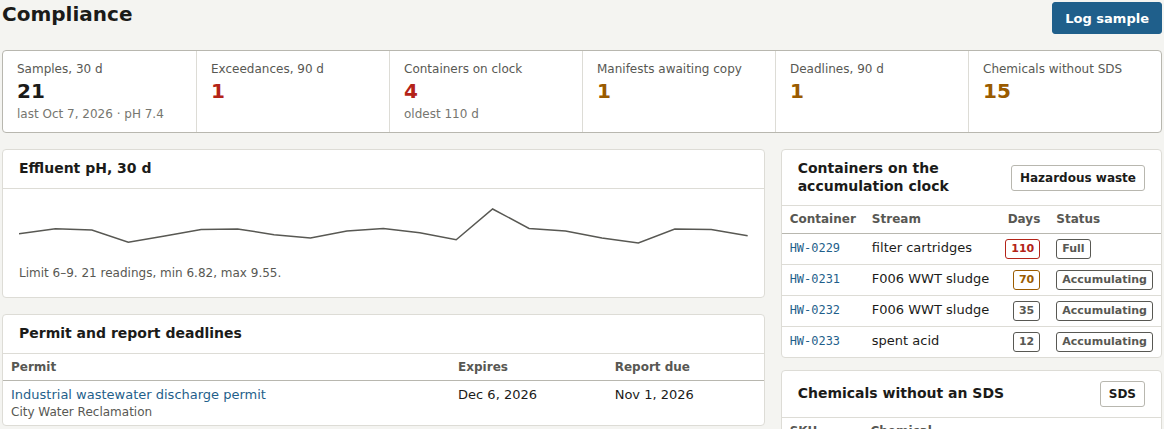

Compliance dashboard with a container at 110 days. Sample shop.

Wastewater

Environmental > Wastewater keeps the self-monitoring the permit asks for, with tabs for Overview, Samples, Limits, Reports, Plant log, Sample points and Settings. The old discharge log's entries were copied in, and its old link opens this page.

Sample points are where samples are taken (final effluent, a clarifier outlet, a pretreatment step), each with its permit and whether it is a combined wastestream. Record a sample takes the point, the date and time, grab or composite (by flow or by time), who took it, the chain of custody number, the lab ("In-house" for your own screening), when it was shipped and received, the temperature on arrival, whether the preservation was right, the flow that day and notes. The lab's results go in a grid, then or when they come back: one row per analyte (pH, total chromium, hexavalent chromium, nickel, zinc, copper, cadmium, lead, silver, total and amenable cyanide, TSS, oil and grease, TTO, flow, temperature, or any other the shop names) with the value and unit, a qualifier (< below the reporting limit, ND not detected, J estimated, E above the calibration range), the detection and reporting limits and the method. A result analyzed after its holding time is flagged; the holding times are defaults to check against 40 CFR 136 Table II (verify), and they never block a result.

Limits holds limit sets from your permit: a daily maximum, a daily minimum (for pH), a monthly or 4-day average, and how a non-detect counts in an average. A set of the federal 40 CFR 433 numbers for existing metal finishers ships turned off, marked "check every number against your own permit" (local limits are often stricter; verify every number), and a banner says so until a set is on. Ticking Checked against our permit turns a set on in that person's name; changing any of its numbers turns it off again until someone checks it. Limits a shop had typed for the old discharge log became a set of their own, left on. Where several sets apply to a point, the stricter limit wins.

A result over a limit that is on is an exceedance: administrators, managers and QC are notified, and two tasks are made for the permit's responsible person, "Tell the Control Authority" due in 24 hours and "Resample and send the results" due in 30 days (both settings). A monthly average is a warning while the month is still running, and an exceedance once it is over. The Overview lists the open exceedances with Write what was done and Close. Every morning the server reminds people of exceedance tasks due or late, and of samples sent to the lab more than 14 days ago with no results. The pages flag results over a limit; they never say a shop is compliant.

Reports builds the month or the half year for one point or all: every result with its qualifier, the maximum and minimum, each month's average against its limit, the flow, and the exceedances, as CSV or as a PDF with the TTO certification statement and a signature block (Settings holds the statement, the signer's name and title). The PDF says it was prepared from the shop's records, to check against the permit before signing.

The Plant log is the treatment plant's own record: pH and ORP for each stage of the plant (the stages are a setting), the filter cake, the chemicals used, issued from Chemical inventory to the waste treatment account, and notes. Voiding an entry puts the chemicals back.

Hazardous waste

Environmental > Hazardous waste has two tabs, Containers and Manifests.

Container
Label or ID, waste stream (F006 WWT sludge, spent plating bath, spent acid, spent caustic, cyanide waste, chromium waste, filter cartridges, contaminated PPE and rags, used oil, universal waste, other), contents, EPA waste codes such as F006, D002, D007, container size (55 or 30 gal drum, 5 gal pail, 275 gal tote, roll-off), Accumulation Start Date, storage location and status.
Status
Accumulating, full or shipped. The days on the clock count from the accumulation start; a container shows amber past 60 days and red past 75.
Manifest
Manifest tracking number, ship date, transporter, designated facility (TSDF), waste description and codes, quantity and unit, disposal cost, and whether the signed copy has come back.

Ship on a manifest opens a form for the manifest details and lists every container on site with the full ones pre-ticked. Recording it marks the ticked containers shipped and links them to the manifest. The Manifests tab shows each manifest's signed-copy state: Awaiting, or Overdue with the day count once 35 days have passed without the facility's copy, with a Mark received button that stamps today's date.

Permits

Environmental > Permits holds permits and registrations: wastewater discharge, air, hazardous waste (EPA ID), storm water, fire and hazmat, business license, Nadcap, ISO / AS9100, ITAR or other, with the issuing agency or registrar, permit number, issued and expiry dates, how many days before expiry to start renewal (default 90; a note for the person responsible, since the dashboard flags every permit 90 days out), reporting frequency (monthly, quarterly, semiannual, annual), the next report due date, the responsible person and the permit conditions. A permit expiring within 90 days or a report due within 30 days appears on the dashboard. Permits import from CSV under Settings > Data.

Safety data sheets

Environmental > SDS lists every inventory item in the chemical, precious metal and anode categories with its location and SDS. An SDS can be a link to the supplier's sheet (the SDS Link field on the item) or a PDF or image uploaded on this page, up to 10 MB. Items with neither show a red "missing" badge and are counted on the dashboard.

Chrome tanks: the surface-tension log

Environmental > Chrome surface tension keeps the log the chromium electroplating NESHAP (40 CFR 63 subpart N) asks of hard and decorative chrome and chromic acid anodizing tanks that meet it with a fume suppressant; tanks on a control device only are not tested this way. Every limit and schedule below ships as a setting, set from the rule as we read it, which is not legal advice. The page shows a Verify banner until an administrator or manager ticks that they checked the numbers against the shop's permit and the current rule; changing a number clears the tick.

Tanks on the log
Add each chrome tank that uses a fume suppressant, with how it meets the rule (fume suppressant, control device or both), the permit and the permit condition, its own limits where the permit sets different ones, the instrument usually used, where its hours of operation come from and the date monitoring started. Untick On the log for a tank taken out of service for good; a tank not in service gets no reminders.
Readings
In dynes/cm, by stalagmometer or tensiometer, with the time, the temperature, the instrument and a note. A stalagmometer reading can be worked out from the drops of DI water and of the sample and the bath's specific gravity. The limits ship as 40 dynes/cm by stalagmometer and 33 by tensiometer (verify against your permit); a reading at the limit passes. A reading over the limit asks for the corrective action, sends the tank back to the first monitoring step, makes a re-test due at once and tells administrators, managers and QC-level people (the Lab technician included). Until a passing re-test, starting a job step or a load in that tank is refused; an administrator or manager can start it anyway with a reason, which is recorded.
When a reading is due
By hours of tank operation, not calendar days. The steps ship as every 4 hours, then every 8 hours after 40 hours without a reading over the limit, then every 40 hours after 40 more (verify against 63.343(c)(5) and your permit). A new bath goes back to the first step, as does a reading over the limit, and the hours until a passing re-test do not count. A reading taken later than its interval starts the count of clean hours again at the same step, which is the cautious reading of the rule (verify).
Hours of operation
One of three sources per tank: its weekly schedule in shop time, with the days it ran other hours or did not run (a shift past midnight included); an hour meter, read on its own or with a reading; or the runs and loads recorded in the tank. A tank's page shows the hours since the last reading and when the next one is due.
Missed readings
Checked every 10 minutes: a warning in the hour before a reading is due, an alert at the due time, and again every 24 hours (a setting) while it is still missing, to administrators, managers and QC-level people; operators are not told. Each notice goes out once.
The record
A reading is never deleted: a wrong one is voided with a reason by an administrator or manager and stays on the log marked void. Corrective-action notes and changes keep who and when. Records are kept 5 years by default (a setting; verify). The log, a summary for a period (readings, readings over the limit, late readings, hours and corrective actions) and the fume-suppressant additions download as CSV in shop time; each fume suppressant can be marked PFOS-free or not.

Anyone with Environmental compliance records readings. The Lab technician, who has Tanks but not Environmental compliance, records them from the tank's own surface-tension page. Setting up tanks, the settings and voids are for administrators and managers.

Hexavalent chromium: exposure and medical records

Environmental > Cr(VI) exposure keeps the exposure monitoring and medical surveillance records of OSHA's hexavalent chromium standard (29 CFR 1910.1026). It is for administrators, managers and the EHS coordinator role only, and the server refuses everyone else. The EHS coordinator role is added once, the first time the page is used: manager level, with Environmental compliance and the time clock. Like the surface-tension log, every figure here is a setting with a Verify banner until someone ticks that they checked it against the current standard.

Exposure results
Per employee and task: sample date, area, kind of sample (personal, area or objective data), minutes sampled, the result as an 8-hour TWA in µg/m³ (or below the reporting limit, or not detected), method, lab, why it was taken and whether a respirator was worn. Each result is shown against the action level of 2.5 µg/m³ and the PEL of 5 (verify). The next monitoring date is worked out: 6 months on at or above the action level, 3 months above the PEL, and none after two results below the action level at least 7 days apart (verify); a date typed in wins. The date the employee must be told is worked out as 15 working days after the result comes back (verify), and the date they were told is recorded.
Medical exams
Exam date and kind (initial, periodic, emergency, termination, symptoms or other), the physician or clinic, when the written opinion was received and when it was given to the employee, where the medical file is kept, and the next exam, 12 months on (verify). The opinion is due 30 days after the exam and to the employee within 14 days of receipt (verify). Keep only dates and the written opinion here; test results and diagnoses stay with the clinic. A person with a result at or above the action level in the last 12 months and no exam on file shows "Offer an exam".
Reminders and records
A daily check tells administrators and managers about monitoring and exams due within 30 days or overdue, and results the employee has not been told yet. Records are voided with a reason, never deleted. Lab reports and written opinions can be attached as files. Both lists download as CSV. Exposure records are kept 30 years and medical records for the length of employment plus 30 years (29 CFR 1910.1020; verify).

Retention and roles

The hazardous waste page states the three-year retention that applies to its records. Wastewater records stay in the shop's database with everything else; how long they must be kept is in your permit (often three years; verify). The chrome records' retention is above. Samples, results and the plant log can be recorded by any staff login with the module; limit sets and the wastewater settings are for administrators and managers; recording manifests, marking copies received, voiding samples and results and uploading SDS files need an Office, QC, Manager or Administrator role. Every action is in the audit trail under Setup. Shops that do not need the module can switch it off under Settings, which removes the Environmental group from the menu.
